Prefab Homes in Ontario 2026: Real Costs, Real Timelines, and the Stuff Sales Brochures “Forget”

Prefab Homes in Ontario 2026: Real Costs, Real Timelines, and What the Brochures Leave Out
Prefab homes can be a smart move in Ontario – especially when trades are booked solid and the weather is doing its usual Ontario thing. But if you’re here because someone promised half the time and half the cost, let’s gently set that brochure down on the table and show you where the real money and real delays actually hide. Spoiler: prefab doesn’t delete costs, it moves them – and sometimes it creates brand-new ones (hello, crane day).
Weighing prefab against solid-wood construction? See our honest guide to building a log home in Ontario — what it really costs, how log walls meet the energy code, settling and long-term upkeep.
First: “prefab” means three different things in Ontario
In Ontario, “prefab” is a catch-all that gets used for everything from a true modular home to a panelized kit to something that looks suspiciously like a cottage shed that got promoted to “executive housing.” Before you fall in love with a floor plan, know exactly which one you’re buying.
Modular
Big chunks of the house – rooms or sections – are built in a factory, shipped to your lot, and set with a crane onto a foundation. This is what most people mean by “prefab home.”
Panelized
The factory builds wall, roof, and sometimes floor panels. Assembly on site is faster than traditional framing, but it’s still very much an on-site build.
Pre-cut kits
Materials cut to length and delivered. Saves some waste and layout time, but still needs a competent crew and real supervision to become a house.
The biggest 2026 myth: “prefab is always cheaper”
Prefab can be cheaper in specific situations. It can also be the exact same cost as site-built, and occasionally it lands higher – especially when site conditions are tricky. The trouble is that prefab quotes are often presented like a car ad: a shiny base number, then a long list of “options” that are basically required if you want a house that feels like a house. The honest way to think about it is that there are two budgets, not one.
| Factory (manufacturer) budget | Site (your lot) budget – often not included |
|---|---|
| Modules or panels and factory finishes, to the level you paid for | Driveway access, staging area, delivery routing, and crane-day logistics |
| Standard specs (often basic unless upgraded) | Excavation, foundation or slab, drainage, backfill, and grading |
| Plant quality program and inspections (if certified) | On-site connections: plumbing, electrical service, HVAC completion, HRV/ERV |
| Some interior completion (varies by product) | Porches, decks, steps, exterior flatwork, landscaping, and often the garage |
| Delivery sometimes included, sometimes not | Permits, engineering, surveys, septic and well if rural, utility trenching, restoration |
What actually drives prefab cost in Ontario (with real 2026 numbers)
If two people buy the same modular model, one can finish with a “that was painless” story and the other with a thousand-yard stare and a spreadsheet of surprise invoices. The difference is rarely the house – it’s the lot, the scope, and the assumptions. Here’s where the money actually goes, using the same regional figures we use on our build-cost pages:
| Site-budget item | Typical 2026 range (Simcoe / Georgian Bay) | Included in a prefab quote? |
|---|---|---|
| Foundation / slab + excavation | tens of thousands, site-dependent | Usually not – and modular demands it be dead-on |
| Well (rural) | $9,000 to $24,000 | Almost never |
| Septic (rural) | $22,000 to $38,000 | Almost never |
| Delivery + crane day | a mini-project of its own | Sometimes; “sometimes” is doing heavy lifting |
| Site work + servicing | $20,000 to $100,000+ | No |
| Finishes above “base” | the silent budget-buster | Only to the level you paid for |

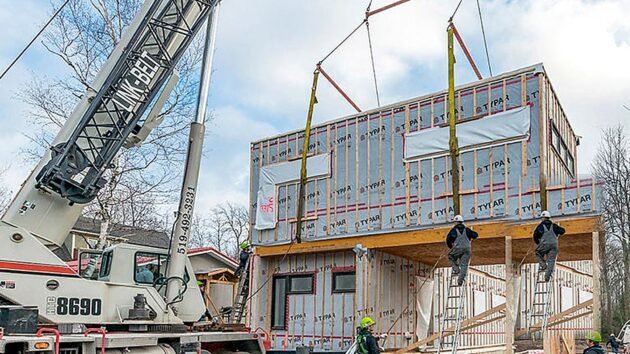

Crane day is not “a fee”
It’s a mini-project: route planning, escorts if needed, staging space, safe lifting, weather windows, and sometimes road restrictions. A tight, wooded, steep, soft, or remote lot turns crane day into a military operation, with invoices to match.
Modular is not forgiving
Site-built framing tolerates tiny corrections as you go. Modular can’t – you’re dropping a finished box onto a foundation that must be dead-on for layout and elevation. If the foundation is off, you don’t massage it, you pay to fix it.
The two site-cost items that swing prefab budgets hardest are the foundation choice and rural servicing. Prefab doesn’t remove those – it just arrives after you’ve already paid them. More on both: septic systems on a lot and well water on a lot.
Timeline truth: prefab can be faster, but it’s not a teleportation device
Prefab is often faster on the framing-to-drywall stretch because the factory works while you do site prep. But Ontario schedules still have gates you can’t skip: design finalization, engineering, permits, utilities, septic approvals if applicable, and inspections. Modular shortens some of the messy on-site time – it does not eliminate the boring paperwork time, and boring paperwork time is still time.
| Phase | What happens | Where delays show up |
|---|---|---|
| 1. Design + scope lock-in | Finalize plan, specs, options, structural assumptions | Indecision – later changes are expensive |
| 2. Permits + approvals | Municipal review, grading/site plan, septic/well steps | Missing documents, revisions, regional backlogs |
| 3. Site work + foundation | Access, excavation, foundation, drainage, backfill | Weather, rock, groundwater, soft soils |
| 4. Factory build | Modules or panels built under the plant process | Supplier lead times, spec changes, scheduling |
| 5. Delivery + set day | Transport and crane placement | Weather and site readiness |
| 6. Site completion | Connections, finish work, exterior, inspections | Trade availability, deficiencies, touch-ups |
The book that prices the half of a prefab project the brochure ignores
Prefab contracts cover the factory. This covers the lot – the site and servicing costs that decide whether prefab is actually cheaper. Each $29.99, or get both below and save.
The Ontario Lot-Buying Bible
The 28-page step-by-step that budgets the whole project the way the money actually flows – land, site work, foundation, well, septic, servicing, financing, HST, and a real contingency. Exactly the site budget a factory quote leaves off. Printable worksheets included.
- The site-budget and total-move-in worksheet
- Well, septic, and site-work cost planners
- The 10-minute go/no-go test and printable scorecard
- Bonus chapters: DIY trades, wells, easements, negotiation
The Ontario Building Permit Bible
Everything a builder does to run a permit – the order of operations, the complete-application checklist, real 2026 fees, and how factory documentation and on-site inspections fit together. So the compliance path is clear before you sign.
- The complete-application checklist, so the file doesn’t bounce
- How factory vs on-site scope gets inspected and documented
- Real 2026 permit fees and development charges
- How to never fail an inspection – and the costliest mistakes
Buying a lot and putting a home on it? Get both Bibles.
Budget the land and the whole project, then run the permit – prefab or site-built – without the guesswork.
Permits, inspections, design, and financing – the parts prefab can’t skip
A prefab or modular home in Ontario still must comply with the Building Code and still needs permits and inspections. Because some components are built off-site, the pathway often relies on factory documentation, labels, and certified processes, so ask early: “How does your product demonstrate code compliance, and what documents will my municipality want?” Work backwards from your municipality – some have a clear internal process for factory-built projects and some are still building their playbook. Either way, get in writing a scope list that states what is completed in the factory versus on-site, and how each portion is inspected and signed off. Your municipality does not approve houses on vibes and good intentions. (Baseline: how to obtain a building permit in Ontario.)
On design, prefab shines when the plan is clean, efficient, and repeatable – rooms stacking neatly, a rectangular-ish footprint, a defined catalog, and speed valued over total customization. It fights you on big spans, walls of glass, complex rooflines, cantilevers, and structural gymnastics, where stick-built usually wins – along with truly custom plans, tight or complicated sites, and the freedom to change things mid-build. And energy performance is math, not a vibe: the wins come from a tight air barrier, a real insulation strategy, good windows, controlled ventilation, and properly sized mechanicals, regardless of where the box was built. (Sanity-check operating cost early: heat loss calculation for a new home.)
Financing feels backwards, too. Site-built money flows gradually with progress; modular front-loads the factory work, so payment schedules often ask for bigger chunks earlier, while the bank still wants to fund on milestones and security. The fix is planning, not panic – have the lender conversation before you sign a purchase agreement, and ask “how do you fund factory-built work, and what documents do you need from the manufacturer to release draws?” (More: construction financing.)
A Prefab Is Still a New Home – So It Can Qualify for Up To $130,000
People chase a few thousand in factory savings and miss the biggest number of all. Ontario’s enhanced HST rebate puts up to $130,000 back in a new-home builder’s pocket if the build contract is signed (or your own build started) before April 1, 2027 – and a modular or panelized home is a new home. Miss the deadline and you fall back to the standard $24,000.
Estimate based on Ontario’s 2026 enhanced HST rebate (Bill 114). Final eligibility for a custom, modular, or owner-built home is confirmed by a licensed rebate specialist – that’s what the free check is for. Full HST rebate details
What is NOT included in most prefab contracts (read this twice)
If one section saves homeowners the most money and sanity, it's this one. Most prefab contracts focus on the factory deliverable, but your real move-in scope is bigger - usually much bigger.
Commonly missing
- Land purchase, legal costs, surveys
- Soil tests, grading plans, site-plan requirements
- Tree clearing, driveway, culverts, access roads
- Excavation, foundation, drainage, backfill, rough grading
- Septic and/or well (common on rural lots)
- Utility trenching and long service runs
Forgotten until late
- Porches, decks, exterior stairs, landings, railings
- Garage (many packages exclude it or treat it as separate)
- Exterior flatwork: patios, walkways, driveways
- Final HVAC commissioning and on-site connections
- Interior touch-ups after transport (normal to need them)
- Taxes and project insurance, depending on the deal
Red flags: how people get hurt in prefab deals
- Vague scope. If you can't tell who does what, you will pay twice for something - guaranteed.
- Too-good pricing. A low number usually means excluded finishes, excluded site work, or unrealistic allowances.
- No clear compliance path. "We've done this before" is not the same as documentation your municipality will accept.
- Deposit pressure. If the deal relies on urgency instead of clarity, that's not a deal, it's a trap.
- Unclear warranty responsibilities. Who handles callbacks - factory, installer, or "someone else"?
Related guides and tools
Prefab homes in Ontario: frequently asked questions (2026)
Are prefab and modular homes legal permanent homes in Ontario?
Yes, when they are designed, built, and installed to the required standards and permitted properly. In Ontario your municipality still expects Building Code compliance, documentation, and on-site inspections for the parts completed on your lot, so factory-built is not a shortcut around permits, it is a different construction pathway. A true modular or panelized home, set on a proper permanent foundation and finished to code, is every bit as much a permanent home as a stick-built one, and it is treated that way for occupancy, financing, and resale. The key is clarity on what is completed in the factory versus what is completed on-site, and on how each portion is inspected and signed off, because that documentation trail is what lets the building department approve the home. Where people run into trouble is not the legality of prefab itself, it is discovering late that the compliance paperwork is thin or the on-site scope was never clearly assigned, which turns a legal, permittable home into a scramble.
How much cheaper is a prefab home in Ontario in 2026?
Sometimes it is cheaper, often it is similar, and occasionally it is more, and the honest answer depends almost entirely on your site costs and how complete the factory package really is. The factory price is only half the picture, because the site budget - access, excavation, foundation, drainage, well and septic on a rural lot, utility runs, and all the finishing scope that makes a house livable - can add tens of thousands of dollars, and in our region servicing alone runs roughly nine to twenty-four thousand for a well and twenty-two to thirty-eight thousand for a septic system before you touch the foundation. Many prefab quotes look cheaper precisely because they exclude those move-in items, along with porches, stairs, exterior flatwork, better finishes, and sometimes key mechanical completion. The only comparison that means anything is total move-in cost against total move-in cost, factory scope plus site scope, and when you build that full picture the dramatic savings a brochure implies usually shrink to something modest or disappear.
What is the fastest realistic timeline for prefab in Ontario?
Prefab can shorten the on-site build portion because the factory works in parallel with your site prep, but it does not skip the gates every Ontario build faces: design finalization, engineering, permits, and often utility and septic steps. A realistic expectation is that prefab may trim weeks to a couple of months off a typical site-built schedule when the planning is tight and the site is straightforward, mainly by compressing the framing-to-drywall stretch. The catch is that if approvals drag, documents are missing, or the site is complex with rock, groundwater, or difficult access, those same bottlenecks absorb the time savings and you end up on a schedule that looks a lot like a conventional build. Prefab also forces decisions earlier than stick-built, because changes after the factory starts are expensive, so the speed advantage rewards people who can lock their plan and specs and punishes people who like to keep tinkering. Treat prefab as a way to remove weather risk and parallelize work, not as a teleportation device.
What is the biggest hidden cost in prefab projects?
Site work, almost every time. Delivery and crane day can be significant, and on a tight or remote lot the crane day becomes a real mini-project with routing, staging, and lifting logistics, but the largest budget swing is usually the ground itself: excavation, foundation accuracy, drainage, backfill, utility runs, well and septic, and the finishing scope that was never in the factory contract. The reason these feel hidden is psychological, because they do not feel like part of buying the house even though they are exactly what makes the house legal and livable, so a buyer anchored on the factory price experiences them as a series of unwelcome surprises rather than as the second half of the real budget. Modular adds one more wrinkle, because the foundation has to be dead-on for the set, so any correction is a paid fix rather than an on-the-fly adjustment. The protection is to demand a complete scope map up front - factory scope plus site scope equals move-in scope - so nothing arrives as a surprise invoice.
Does a prefab or modular home qualify for the Ontario HST new-home rebate?
Generally yes, because a modular or panelized home built as a new residential home is still a new home for tax purposes, and Ontario's enhanced HST rebate can return a substantial amount on a qualifying new build if the contract is signed or your own build is started before the April 1, 2027 deadline, worth up to one hundred and thirty thousand dollars at the top before it phases down, compared with the standard rebate of around twenty-four thousand. That is a far bigger number than the few thousand dollars people often chase in factory savings, which is exactly why it belongs in the comparison from the start rather than as an afterthought at tax time. Eligibility depends on the specifics - who owns the land, how the contract is structured, whether it is a custom, owner-built, or purchased new home, and the timing relative to the deadline - so the rebate is confirmed by a licensed specialist rather than assumed. The practical point is that ignoring the rebate can cost you more than any prefab-versus-site-built price difference, so confirm your eligibility early and factor the net number into your decision.
Can prefab homes go on a slab-on-grade in Ontario?
Often yes, but it depends on the product, the mechanical approach, and how the modules or panels are designed to be connected and serviced. Some modular approaches historically leaned toward basements or crawlspaces because they make routing plumbing, electrical, and HVAC connections between and beneath modules easier, but many modern designs work well on slab-on-grade when the servicing is planned early. The risk is not the slab itself, it is making sure the mechanical, electrical, and plumbing connections are laid out before the set and that the foundation tolerances are correct, because a modular set is unforgiving of a foundation that is out of level or off on layout. Slab-on-grade can also pair nicely with in-floor radiant heat and a tight envelope, which suits our climate, but the decision should be made with the manufacturer's connection details in hand rather than assumed. As with everything prefab, the slab is fine when the plan behaves and expensive when the connections were an afterthought.
Do prefab homes hold resale value in Ontario?
Resale value is driven far more by location, layout, finishes, energy performance, and overall quality than by whether the home was built in a factory or framed on-site, so a well-designed, well-finished, code-compliant modular home on a proper foundation generally holds value like any comparable house. The caveat is perception, because some buyers and even some agents confuse true modular homes with mobile or manufactured housing, which occupy a different market, so in certain areas a modular home can face a perception discount that has nothing to do with its actual construction. The best protection is to build a home that reads unmistakably as a solid, permanent Ontario home - a good foundation, a good envelope, quality finishes, properly sized mechanicals, and a clean documentation trail that reassures a future buyer and their lender. Do that and the factory origin becomes a footnote. Cut corners on finishes or foundation to hit a low headline price and you create exactly the resale drag people fear, whether the home was built in a plant or on the lot.
Note: general information for planning, not legal, tax, or engineering advice. Prefab product types, code-compliance pathways, municipal processes, financing, and HST eligibility vary by situation and change over time - confirm the specifics with your municipality, lender, and a licensed rebate specialist before you commit.
So, is a prefab home a good idea for you?
If your plan is efficient, your site is straightforward, and you want a predictable build with fewer weather headaches, prefab can be a smart play. If you want a one-of-a-kind custom design, big spans, major glass, or you expect to change your mind mid-build, stick-built may actually be the calmer - and sometimes cheaper - path. The winning move in 2026 is simple: compare total move-in cost, demand a clear scope map, confirm your HST rebate eligibility, and don't sign anything until the permit and compliance pathway is understood.
